Guide: Rotaking Beta
How Do Core Concepts Map to Tenzo?
Key: ✅ Supported 🚸 Work in Progress ❌ Not Supported
![]() |
![]() |
|---|---|
| Location | ✅ Locations |
| Shift (actual) | ✅ Worked shifts (approved or not) |
| Shift (planned) | ✅ Published shifts |
| Hours | ✅ Shift hours |
| Employee | ✅ Employees, including leavers, with hire and termination dates |
| Role | ✅ Job titles |
| House Part | ✅ Departments |
| Leave (holiday, sickness) | ✅ Sickness, annual leave & other paid leave — loaded as paid time off, kept separate from worked labour |
| Pension | ✅ Employer pension contribution |
| Salaried workers | ✅ Cost provided per shift by Rotaking |
| Shift cost | ✅ Provided per shift by Rotaking |
| Holiday accrual | ✅ Accrued on each worked shift (salaried absorbed into salary) |
| Breaks | ✅ Paid and unpaid break minutes |
| Employer taxes (NI) | ✅ Provided per shift by Rotaking |
| Labour additions | ✅ Daily labour additions, loaded as a "Labour Additions" line per location |
| Agency staff | ✅ Agency staff shifts and costs, loaded alongside employee shifts |
| Open shifts | ✅ Unfilled shifts, loaded into the forecast as an "Open Shift" employee |
| Revised forecast labour | ✅ Rotaking's locked 00:01 labour snapshot, replacing the day's forecast labour once available — optional |
| Overtime | ❌ Not Supported |
| Overheads | ✅ Tag cost |
| Borrowed / loaned employees | ❌ Not Supported |
| Unapproved labour | ✅ Shifts that are not approved. Not included in default labour cost or hours. Can be reported on separately in Tenzo. |
| Sales Forecast | ✅ Forecast sales (Financial screen) — optional |
Data Ingestion
| Real-time optionally available? | ❌ |
| Default polling frequency | Every 8 hours |
| Data retrieved on each poll | This week Forward three weeks Back two weeks |
| Historical data | From the start date entered at setup ("Earliest date to pull costings from") |
Importing Rotaking's Sales Forecast (Optional)
As well as labour data, Tenzo can pull Rotaking's own sales forecast in — the same effective forecast figure shown on Rotaking's Financial screen. Once a week is locked, that is the forecast adjustment rather than the original forecast, so Tenzo follows whatever Rotaking is currently working from.
It is off by default and opt-in per business. To enable it, tick "Pull Rotaking sales forecasts" during setup and map each Rotaking venue to its Tenzo location — only mapped venues are imported. The forecast comes through at daily granularity (one value per location per day, with every revenue stream Rotaking counts towards the venue total added together), and is refreshed daily for yesterday and the coming fortnight.
How Do I Compare Rotaking Data to Data in Tenzo?
Compare against the Financial overview in Rotaking (the same figures shown on your Rotaking Financial page). Total worked hours should match closely.
Labour cost is provided per shift by Rotaking (wage, pension and employer National Insurance) and should match closely. Paid leave such as sickness is loaded as paid time off rather than worked labour, so it sits outside each department's worked labour cost. Paid holiday accrual for salaried staff is absorbed into their salary in Tenzo rather than added on top, so Tenzo's worked total can sit slightly below Rotaking's raw figure.
Rotaking's Actual Labour line is its costed labour plus any labour additions (daily amounts your finance team adds for costs the rota doesn't capture, such as central staff who split their time between sites). Tenzo brings each day's addition in as a zero-hour shift on a "Labour Additions" employee, role and house part, so it counts towards labour cost without adding hours. Forecast labour additions are loaded alongside published shifts, and actual additions appear once the day has started.
Agency staff shifts are costed by Rotaking in the same way as employee shifts and load into actual and forecast labour under the agency worker's name. Open shifts (shifts on the rota that nobody has been assigned to yet) load into the forecast only, on an "Open Shift" employee. Once someone claims an open shift, it appears under their name instead.
Note that shifts crossing midnight are attributed to the day they start in Tenzo, which can shift a small amount of time between days versus Rotaking's own view.

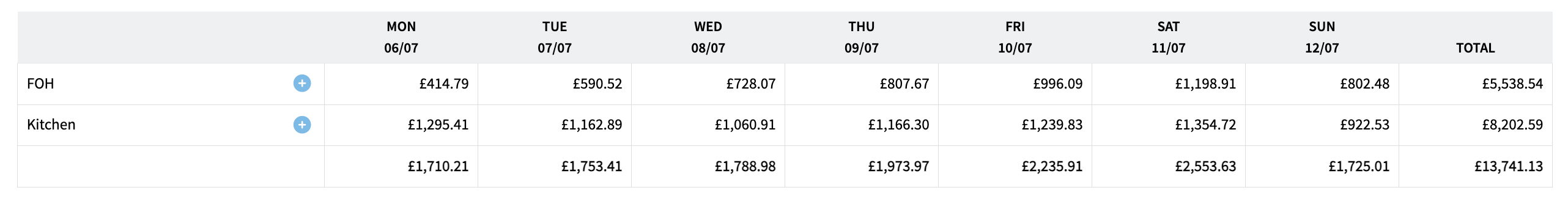

In Tenzo, the Labour by House Part view breaks worked hours and cost down by department (for example FOH and Kitchen), so you can compare each department against the equivalent split in Rotaking:

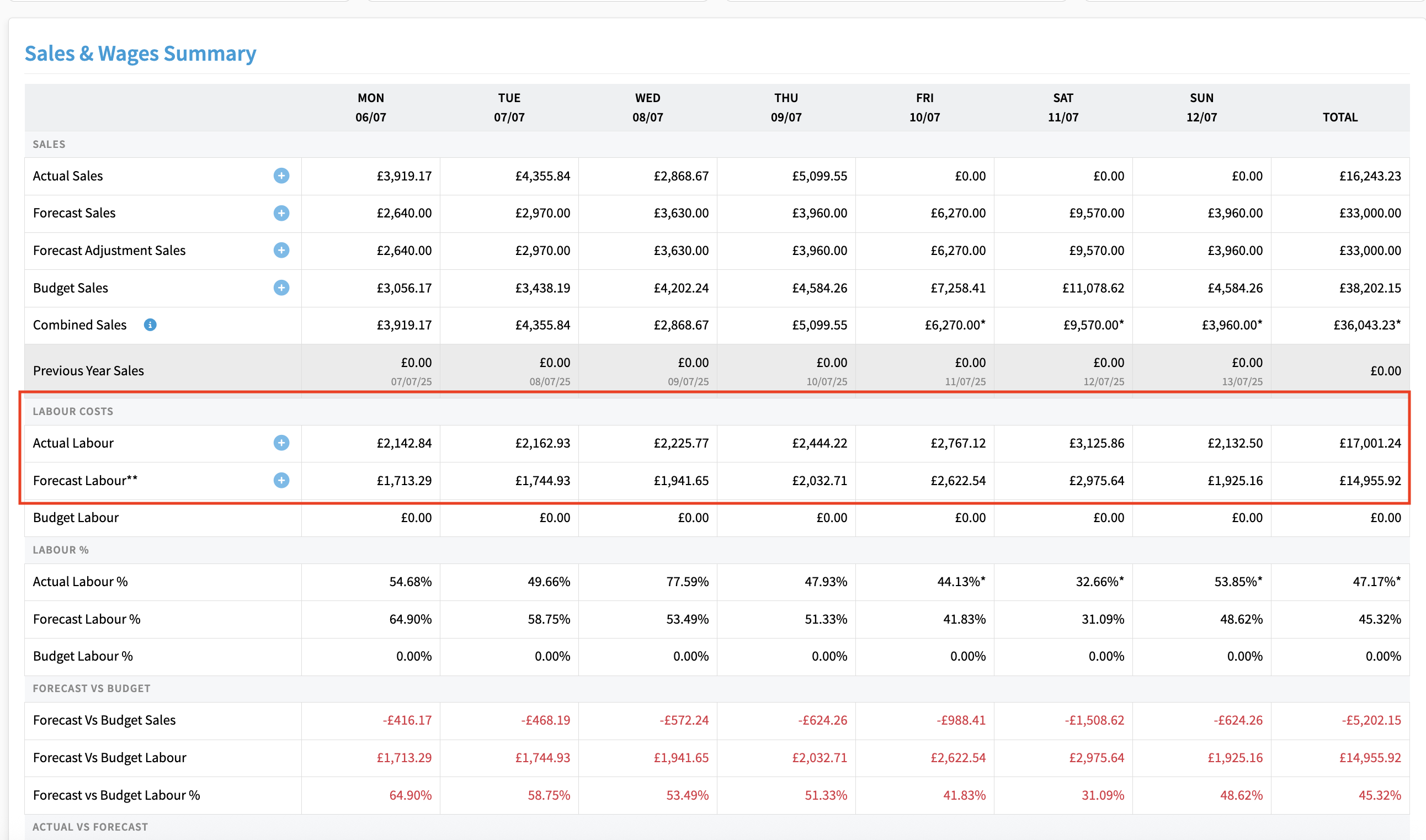

You can also compare actual labour against your forecast. Worked shifts in Rotaking load as Tenzo's actual labour and scheduled shifts load as the forecast, so you can track worked labour against the planned schedule. Shifts still in draft are included in the forecast and flagged as unapproved, so the weeks ahead match Rotaking's Forecast Labour before the rota is published:
The rota remains editable in Rotaking, so the forecast built from it keeps changing up to and through the day. Optionally, Tenzo can use Rotaking's Revised Forecast Labour instead: a locked snapshot of the schedule, released once a week, that no longer moves and so gives a truer forecast to measure actuals against. This is chosen per business with the "Planned labour source" setting, which defaults to scheduled shifts. Once Rotaking has locked a week (from midday on the Monday), its Revised Forecast Labour line (the scheduled labour as it stood at 00:01 on each day) replaces the shift-level forecast for those days. Tenzo loads it as zero-hour rows on a "Revised Forecast Labour" employee and house part, with Rotaking's breakdown as the role: Employee Cost, Agency Staff Cost, Open Shift Cost and Labour Additions. The day's forecast labour cost then matches the Revised Forecast Labour figure on Rotaking's flash report, and forecast hours for that day are not available. Days Rotaking has not yet locked keep the shift-level forecast.
